Gas Compression Facility – Brownfield EPC Execution Schedule – Oil & Gas

Role: Senior Planner
Project Type: Oil & Gas

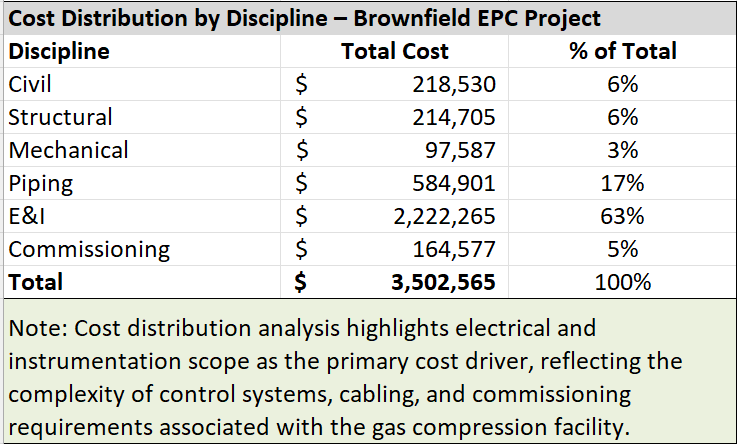

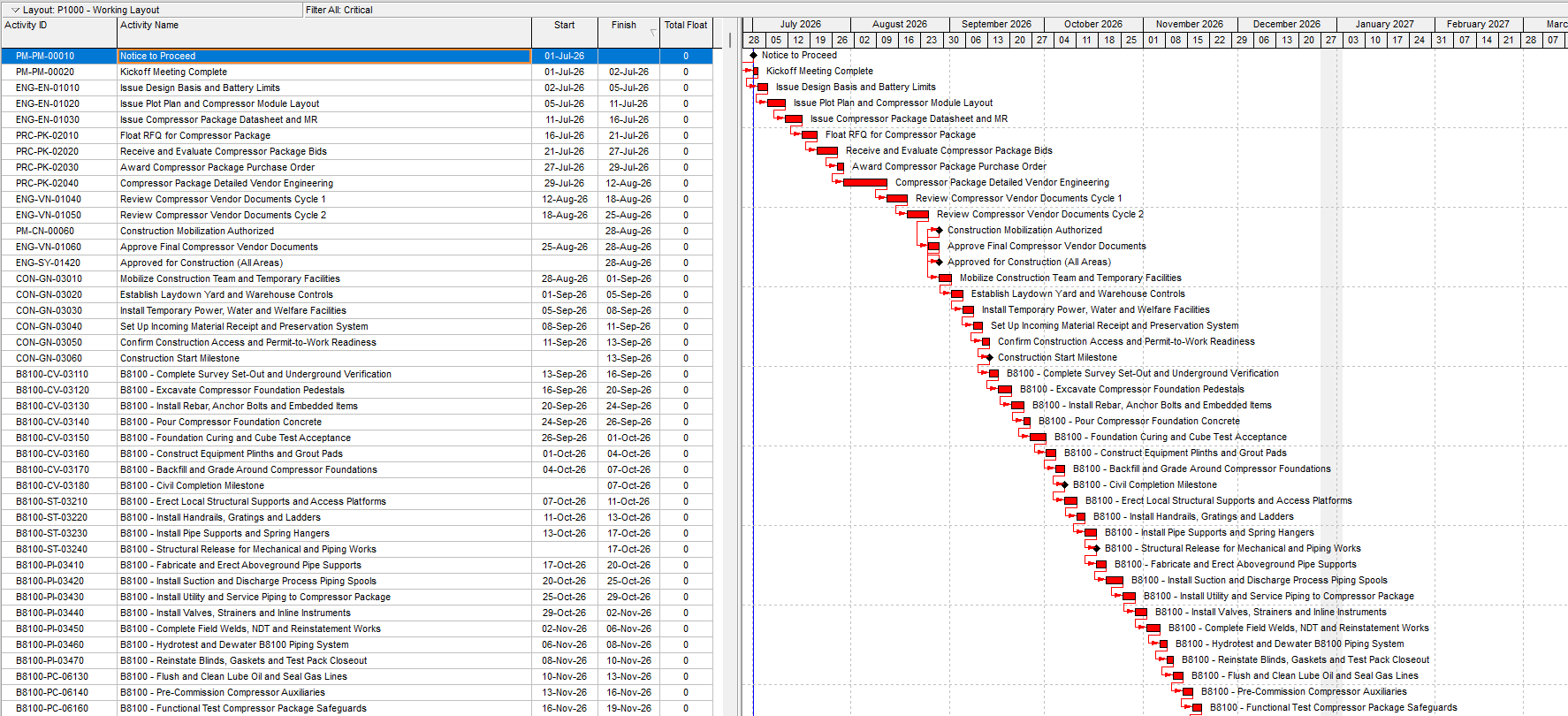

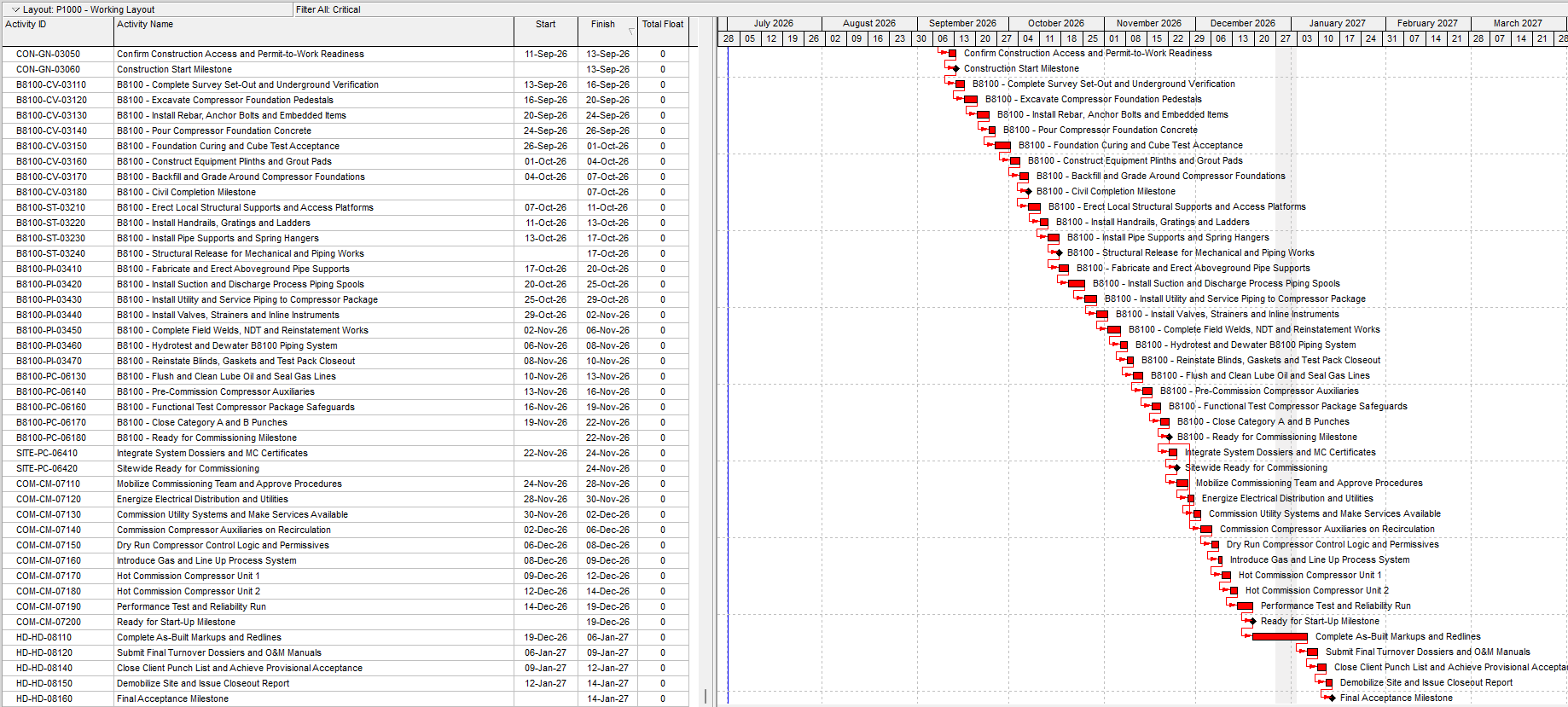

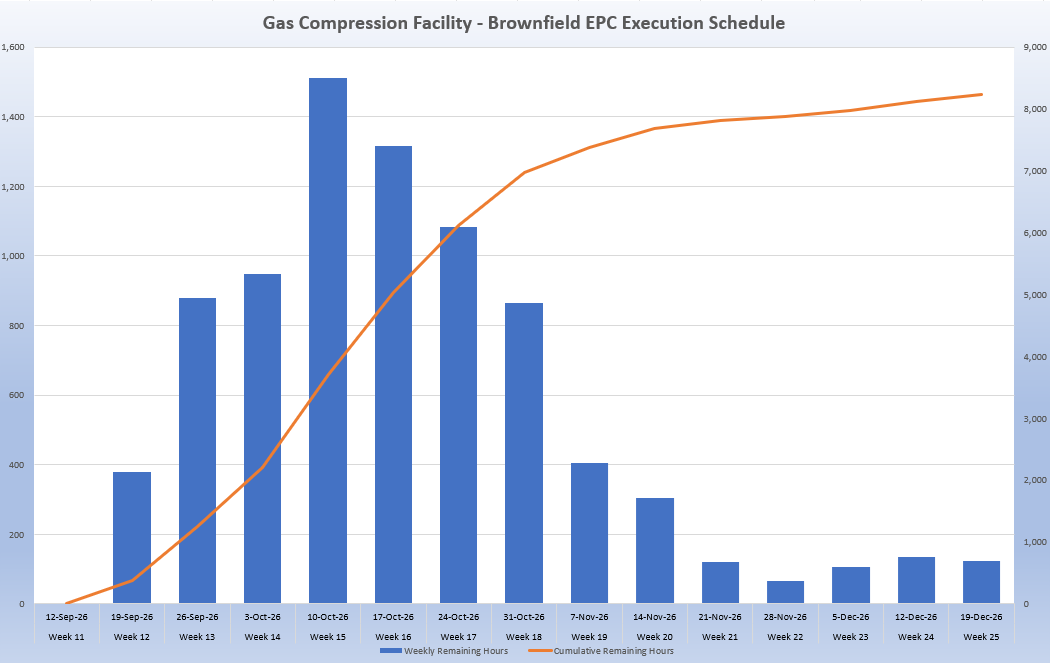

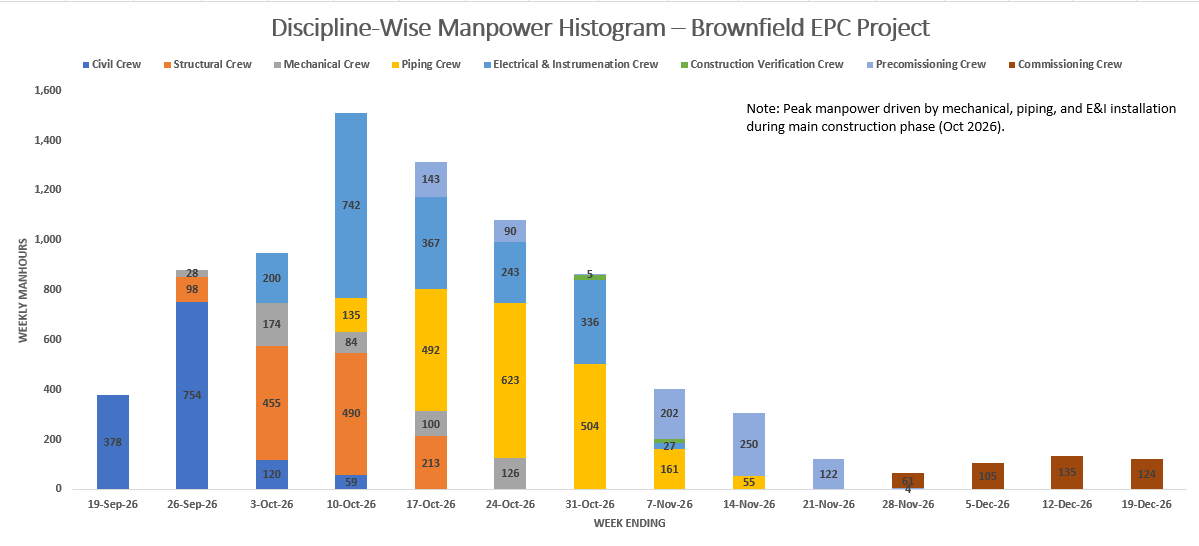

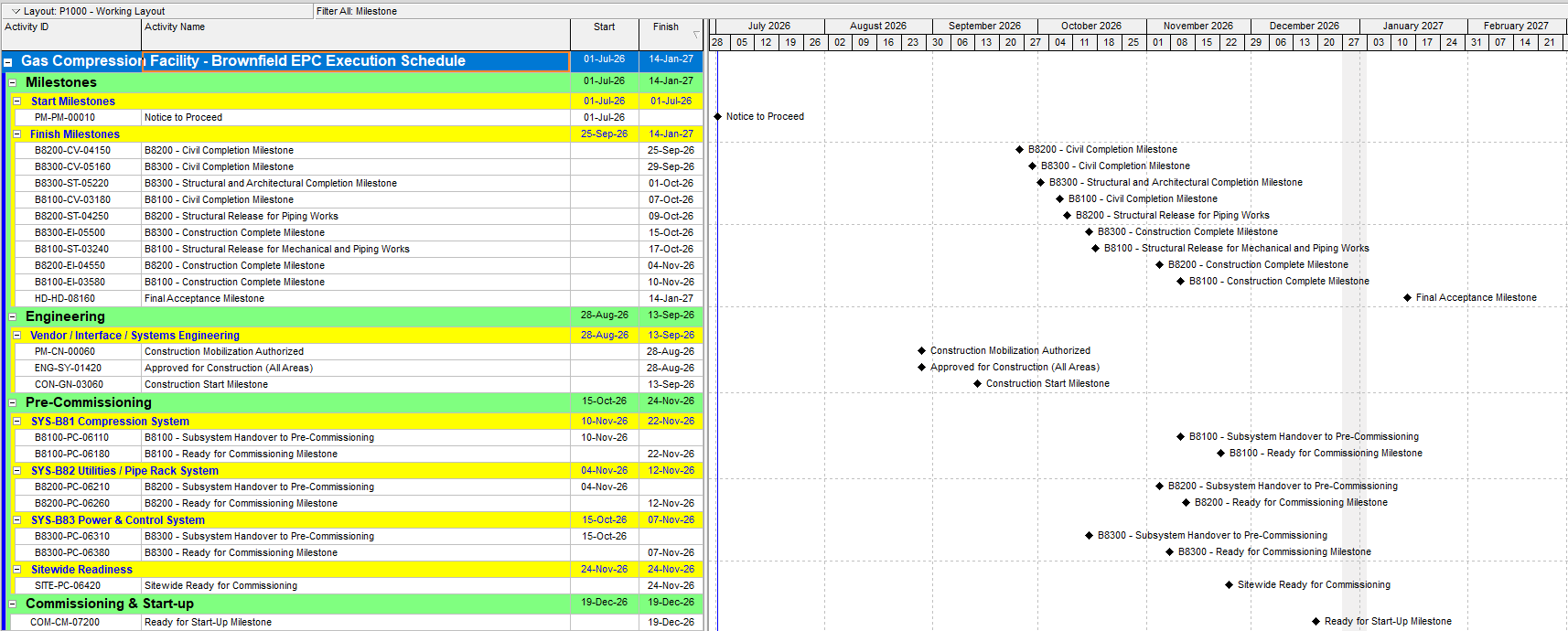

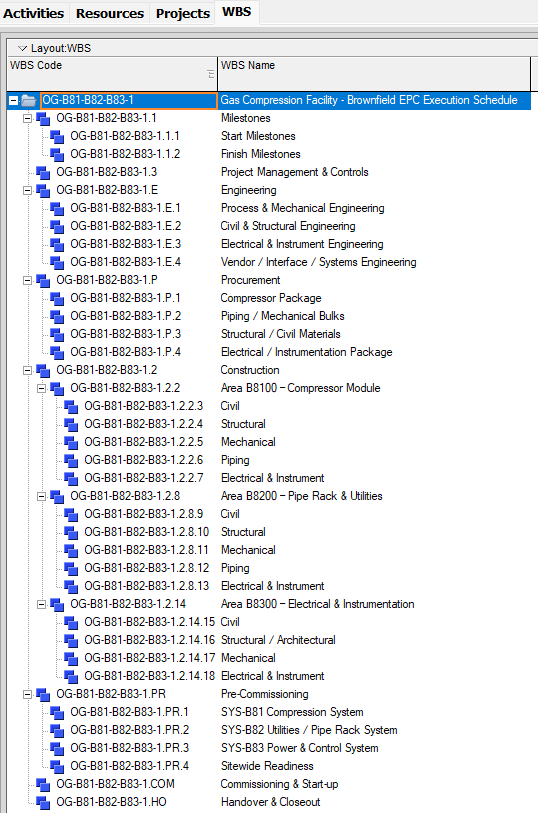

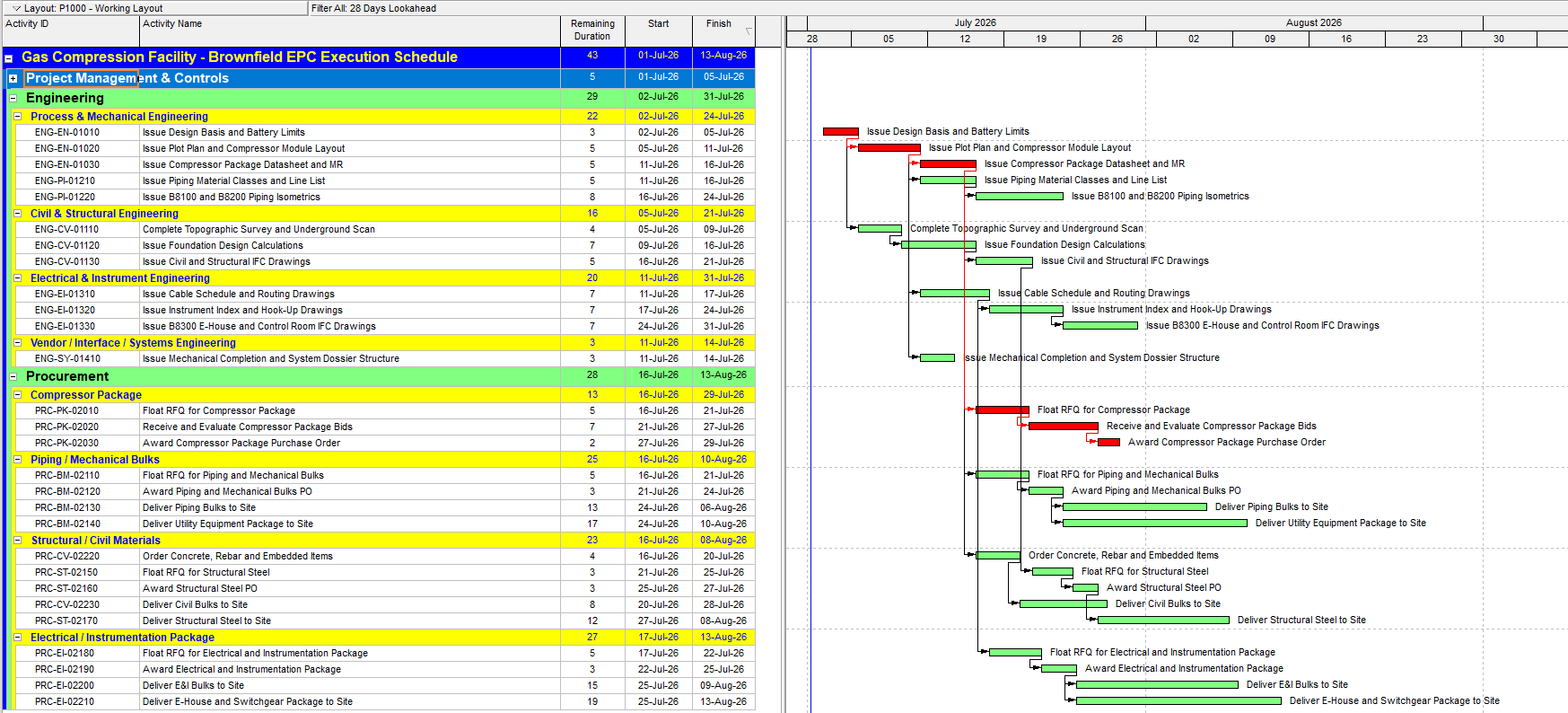

Developed a fully integrated Primavera P6 schedule for a brownfield gas compression project, linking engineering, procurement, construction, and shutdown activities. Implemented structured WBS, resource and cost loading, and critical path analysis to support execution planning and project performance tracking.

Key responsibilities such as:
